Your reorder point is the stock level that has to trigger the next order: average daily usage across the lead time, plus the buffer you keep. Put the three in to see the trigger, the days you have left before you hit it, and what a late truck costs.
Usage and lead time
cases
Cases a day across a normal week, slow days and all.
days
Order placed to truck unloaded, not the date the supplier promises.
What you hold
cases
The buffer you keep under the lead time demand. Sizing it from demand swing and a service level is a safety stock calculator's job; here it is a number you type in.
cases
What is on the floor today, so the days left can be counted.
Stress test the lead time
days
A late truck is the usual reason a reorder point fails. Two days is a common slip on a DSD route.
Reorder point

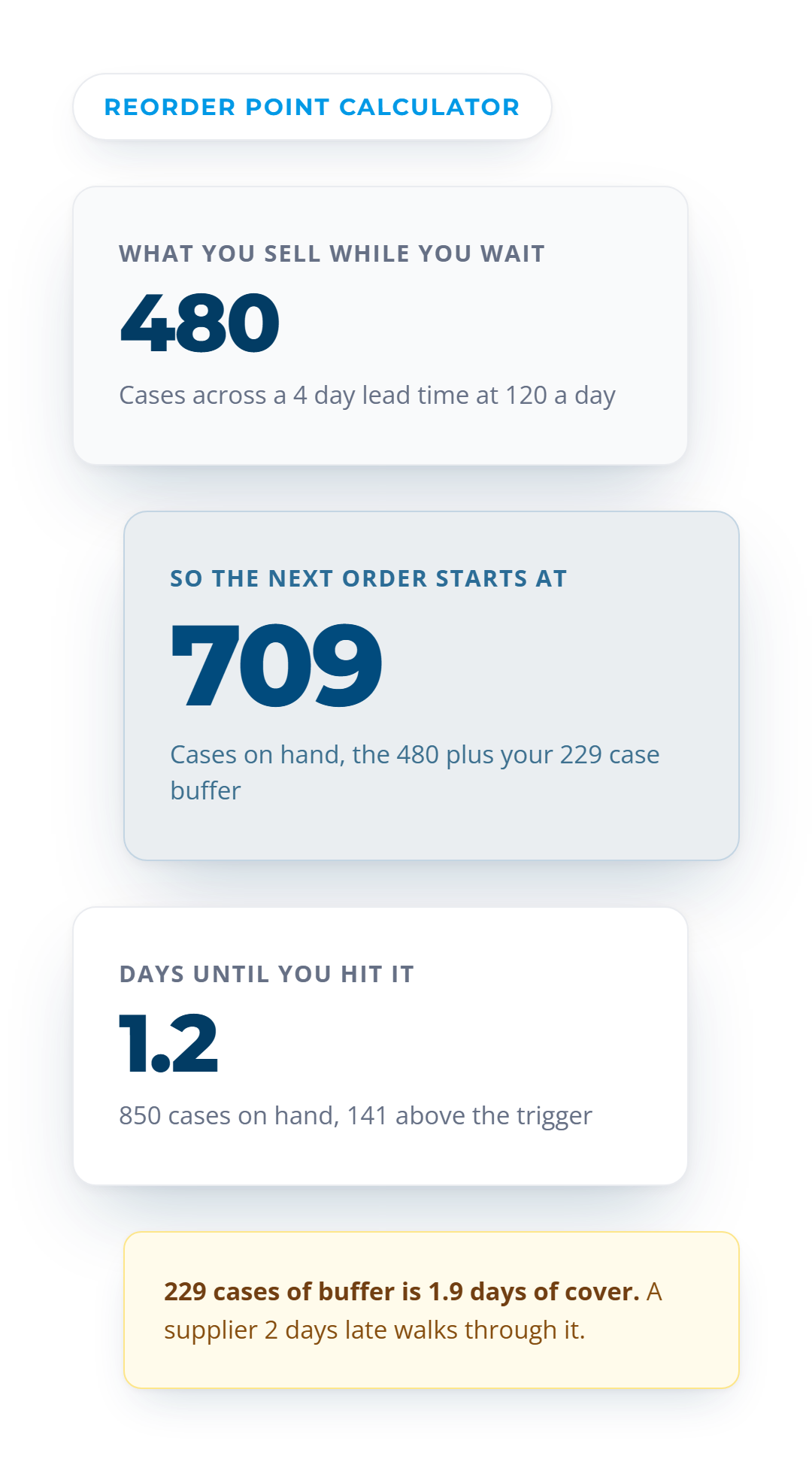

709 cases
480 cases of lead time demand plus your 229 case buffer

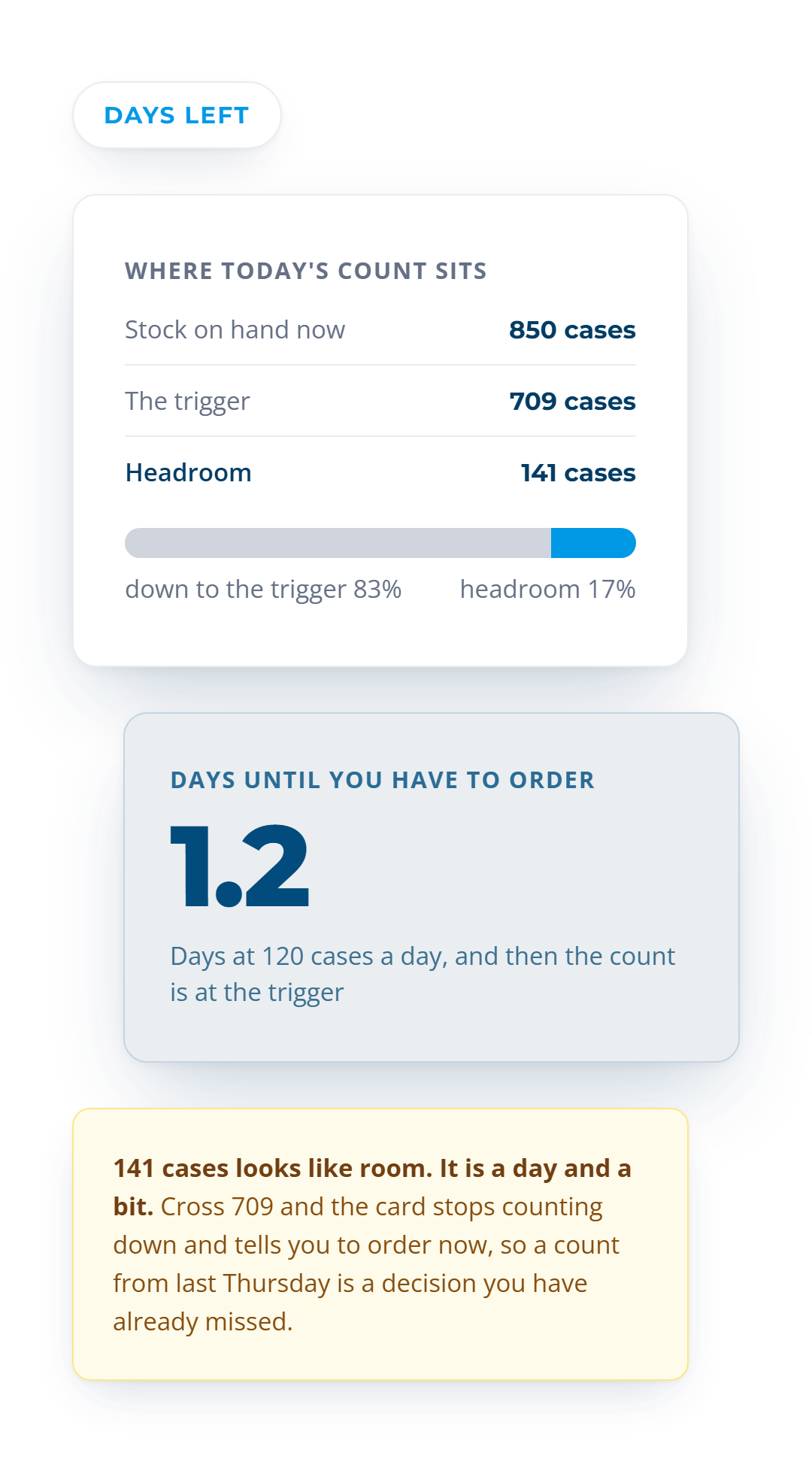

Days until you hit it
1.2 days
850 on hand, 141 cases above the trigger
Demand during the lead time
480 cases
120 cases a day across 4 days

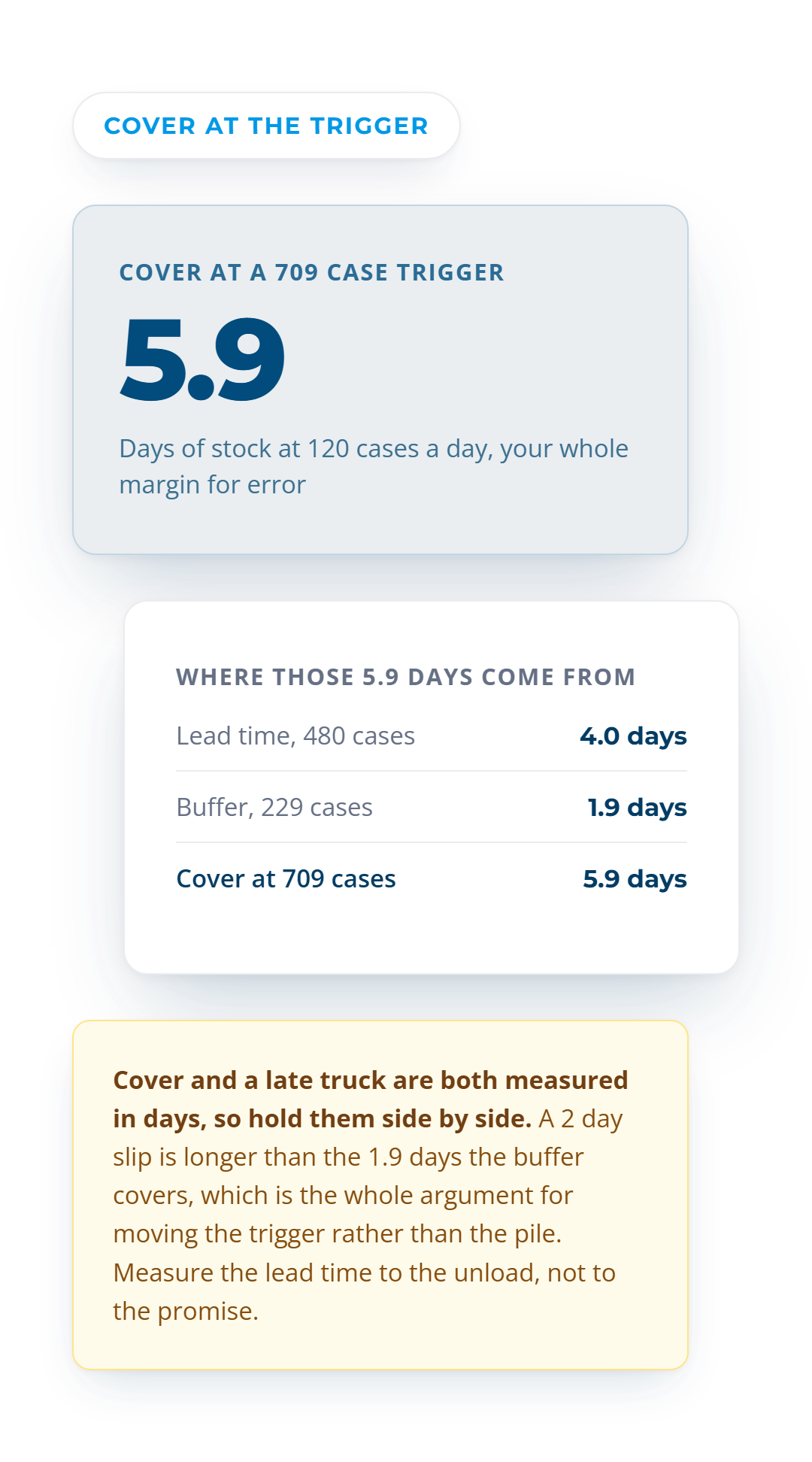

Cover at the reorder point
5.9 days
709 cases at 120 a day

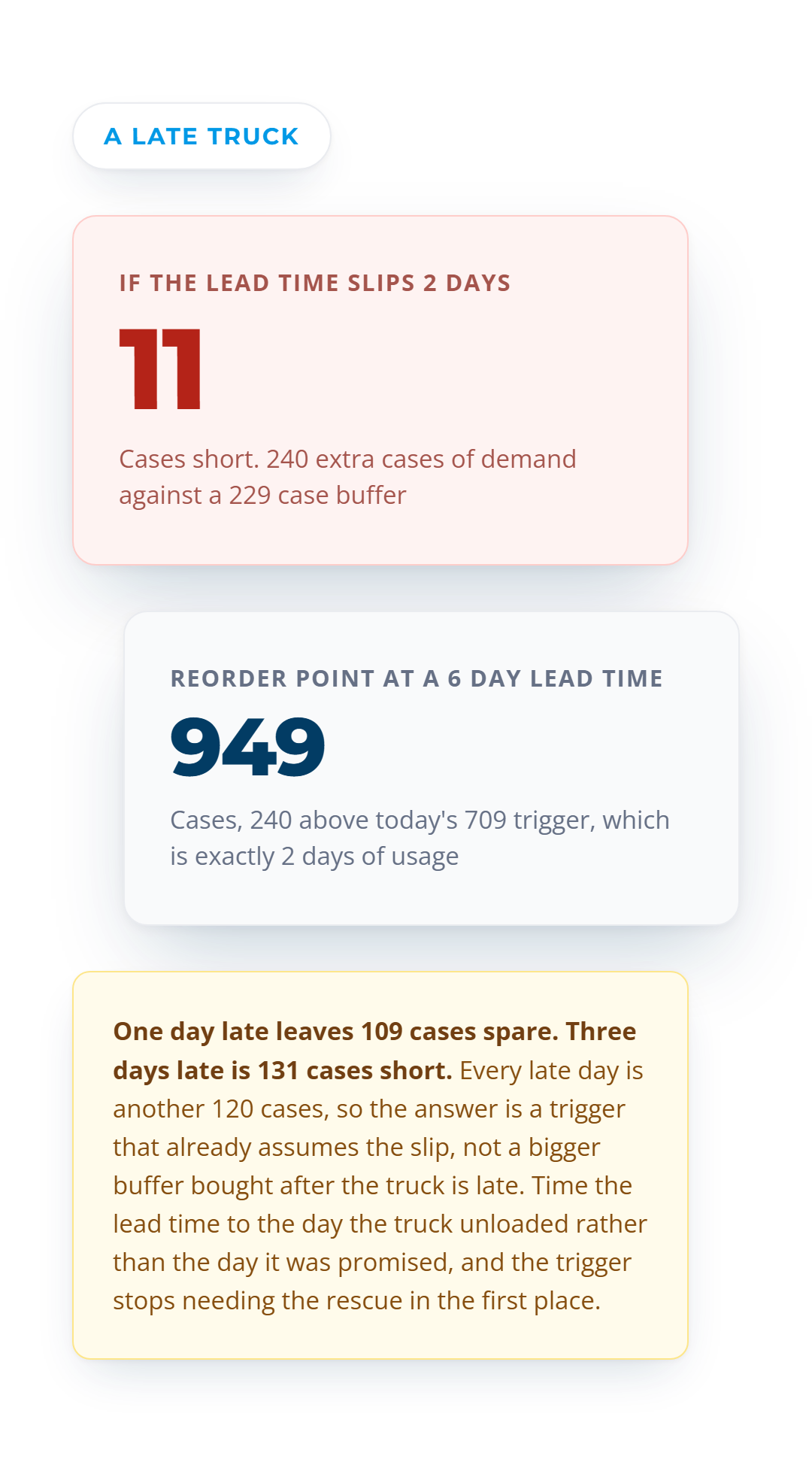

If the lead time slips 2 days
11 cases short
240 extra cases of demand against a 229 case buffer
Reorder point at a 6 day lead time
949 cases
240 cases above today's 709 trigger
Your buffer is 229 cases, which covers a 1.9 day slip, not a 2 day one. A supplier who runs 2 days late walks straight through it and leaves you 11 cases short. Raise the trigger to 949 cases or get the lead time honest, because padding the buffer after the truck is late is not a plan.
Estimates only. This uses the standard reorder point definition, usage across the lead time plus safety stock, and no forecast. Recheck it whenever usage or a supplier's lead time moves.
When exactly should you hit the button?
Six quick questions about one item. At the end you get the level that should trigger the order, and what a late supplier would cost you.
Step 1 of 7
The situation
What brought you here?
Pick the closest one.
Pick one to carry on.
The item
How fast does it move, and how long do they take?
These two together are the demand you have to cover while you wait.
cases/day
Cases shipped, divided by the days you ship.
days
Order placed to product on your dock.
Enter a usage and a lead time above zero.
Your cushion
What buffer do you carry, and what is on hand now?
The buffer is whatever you already decided to hold. This works out when it starts getting used.
cases
The cushion you keep on top of normal lead time demand.
cases
What is actually in the building today.
Those cannot be negative.
When they run late
And how late does your supplier run?
This is the one that turns a comfortable buffer into a short shipment.
days
A typical late delivery, not the worst one you can remember.
That cannot be negative.
How you run it today
What triggers a reorder at the moment?
A trigger nobody sees is a trigger that gets missed.
Pick one to carry on.
When it goes wrong
When a late delivery is going to leave you short, who tells the customer?
Last one before your numbers.
Pick one to carry on.
Your breakdown is ready
Reorder point
--
The headline number. The rest are below.
Want to see your results?
You have given us enough to work this out. Fill this in and the full breakdown opens up.
Loading the form.
The form did not load.Your browser or your network is most likely blocking it. That should not cost you the numbers you just worked out.
Your details go straight to our team, who will follow up about these numbers.
Your result
Working it out.
Here is your breakdown.
Reorder point
--
Days until you hit it
--
If the lead time slips
--
Demand during the lead time
--
Cover at the reorder point
--
A trigger is only as good as the usage behind it.
VoiceOrder Solutions captures orders straight into your existing order guide, so the usage you set this against is the same thing that shipped.
Estimates only. Confirm your usage and lead time before changing a trigger.
709 cases
The level that has to trigger the next order
1.2 days
Headroom left at 850 cases on hand
11 cases
Short if the supplier runs 2 days late
The Basics
What is a reorder point?
A reorder point is the stock level on a line that says the next order has to go in now. It holds enough stock to cover sales until the truck unloads, plus a buffer for surprises. With this calculator's defaults, that level is 709 cases.
Supplier wait time, stated in cases
Time, priced in cases. It takes the days you wait on a supplier and states them as a stock level you can check on the floor.
It misses cases already on order
Cases already on the way. The basic sum checks the floor only, so hold the trigger against stock on hand plus stock on order, or you order twice.
When accounts order on one day
A day of usage is an average. When most accounts order for Monday's trucks, 141 cases of headroom can go in a single morning.
Who It's For
Who uses a reorder point calculator
Buyers at distributors that hold stock in their own warehouse use it to decide when each line needs a supplier order. Whoever places supplier orders should run it for each line, not once for the whole range.
Owners setting buying rules
Buyers comparing supplier lead times
Category managers watching fast movers
Receivers logging real unload dates
Controllers questioning rush freight
DSD teams timing warehouse restocks
Purchasing teams timing deal buys
Warehouse leads flagging low lines
Analysts comparing triggers across SKUs
How It Works
How to use the reorder point calculator
Three numbers set the trigger. A fourth says how long you have, and a fifth tests the whole thing against a late delivery.
1
Enter your usage and your real lead time
120 cases a day across 4 days is 480 cases you will sell while you wait. Measure from order placed to truck unloaded.
2
Add the buffer you already hold
480 cases plus a 229 case buffer puts the trigger at 709 cases. You type the buffer in here, because this tool does not size it for you.
3
Read the days left, then stress the lead time
850 cases on hand gives you 1.2 days before you hit it. Set the slip to 2 days and the trigger needs to be 949 cases.
What You See
What the calculator shows you
The trigger
The stock level that has to start the next order
480 cases of demand across the lead time plus a 229 case buffer puts the reorder point at 709 cases. Subtract the two cards on screen and you get the buffer back.
The sum is simple. The trouble is in the stock and the buffer you feed it, and in the units you count them in.
1
On hand means free to sell
Take out cases already picked or promised to orders that are in. 850 cases on the floor is less than 850 free if tomorrow's orders already claim part of it.
2
A buffer sized for this supplier
The 229 cases you type in were sized for one lead time. Change the supplier or the lead time and size the buffer again before you trust the trigger.
3
One unit in every field
Usage, buffer and the count all have to be in full cases. A count taken in eaches or broken cases makes the days left read wrong.
Sound Familiar?
A reorder point fails on the lead time, not on the math
The arithmetic takes a minute. Choosing the lead time you feed it is the part that decides whether the trigger holds.
We order when the shelf starts to look light.
A look is not a level. At 120 cases a day across a 4 day lead time the trigger is 709 cases, and 850 cases on hand leaves you 1.2 days to get the order placed.
We hold a buffer, so a late truck is covered.
The 229 case buffer is 1.9 days of usage. A supplier who runs 2 days late walks straight through it and leaves you 11 cases short.
The supplier says four days.
Use the day the truck unloaded, not the day it was promised. At a 6 day lead time the trigger is 949 cases, which is 240 cases above the one you run today.
The Comparison
Three ways to decide when to reorder, and which one holds up
Same 120 cases a day, same 4 day lead time, same 229 case buffer. These are the three ways the call actually gets made.
Usage across the lead time plus your buffer compared with A fixed minimum on the shelf compared with Ordering on a weekly routine
What you need before you place the next order
Usage across the lead time plus your buffer
A fixed minimum on the shelf
Ordering on a weekly routine
Names the exact level to order at
Yes
Yes, but the level itself is a guess
No, the day is the rule, not the level
Scales with your real lead time
Yes
No, it never moves with the lead time
No, the calendar does not know the lead time
Keeps the buffer as a separate number
Yes
No, the buffer is buried in one number
No
Says how many days you have left
Yes
No, not without a usage rate
No, it counts days to the order, not days of stock
Shows what a 2 day slip would cost
Yes
Only by luck
No, a slip lands between order days
Works on a fast and a slow mover
Yes
No, the same minimum on both
No, a fast mover runs out midweek
Tells a buyer when, not how much
Yes
Yes
Yes, the calendar says when
Moves when your usage moves
Yes
No, someone has to remember to change it
No
Where it falls down
It trusts the lead time you type, so an optimistic one sets the trigger low
It was set once and nobody knows what it assumed
Usage does not wait for your order day
Best used for
Deciding the day to place an order on a line that matters
What actually decides whether a reorder point holds
Only two of these six sit inside the formula. The other four are why a trigger misses in practice.
Your real lead time
Order placed to truck unloaded, not the date you were given. Each extra day adds 120 cases to the trigger at this usage rate.
Usage counted on slow days too
120 cases a day has to be the average across a normal week. Take it from a busy week and you carry stock you never needed.
The buffer you already hold
229 cases here, typed in rather than worked out. Sizing a buffer from how much demand and lead time swing is a safety stock calculator's job.
Supplier reliability
A 2 day slip costs 11 cases on this line. The cheapest fix is a supplier who unloads on the day they said, not a bigger pile.
How current your count is
A 709 case trigger does nothing against a count from last Thursday. Someone has to see the number cross it in time to act.
Shelf life
Raising a trigger buys cover in days, and on a short life item those days have to clear before the product does.
See how VOS captures orders the day they are placed
Each account orders from a guide built on your own SKUs, and VoiceOrder Solutions captures orders placed after hours, each with its date and timestamp.
VOS does not set your reorder point, count your stock or order from your suppliers. It works on the demand side, where inventory visibility follows order activity as customers order by voice in the VOS app.
Real-time inventory visibility tied to order activity
No. Safety stock is the buffer, 229 cases here. The reorder point adds the demand you sell while you wait on the truck, 480 cases over a 4 day lead time, so the trigger sits at 709 cases.
How is ROP calculated?
Average daily usage times the lead time, plus the safety stock you already hold. 120 cases a day across 4 days is 480 cases, and a 229 case buffer takes the trigger to 709 cases. Measure the lead time from order placed to truck unloaded, because every extra day adds 120 cases.
What is the formula for calculating reorder level?
Reorder level, order point and ROP are three names for the same figure, usage across the lead time plus the buffer. Do not confuse it with a par level, which is the quantity you top up to. The reorder level is 709 cases here and says nothing about how much to order.
What happens if the reorder point is too low?
You run out before the truck arrives, and the buffer absorbs the gap until it cannot. A 2 day slip adds 240 cases of demand against a 229 case buffer, which leaves you 11 cases short. The answer is a trigger of 949 cases, not a call to the account on the day.
How do you find the normal reorder period?
Divide the trigger by your daily usage to see what it covers, then count down from today's stock. 709 cases is 5.9 days of cover at 120 cases a day, and 850 cases on hand leaves 1.2 days before you hit it. How often you order after that is set by how much you buy each time.
What is the formula for calculating inventory level?
Count what is on the floor, then hold it against the trigger. 850 cases on hand against a 709 case trigger leaves 141 cases of headroom, which is 1.2 days at 120 cases a day. If the count is a week old, so is the answer.
How do you calculate the order point?
Set it per line, then make sure somebody sees the count cross it. A trigger of 709 cases is worth nothing if stock gets checked once a week. Reset it whenever the lead time moves, since a 6 day lead time takes the same line to 949 cases.
See the trigger coming in time to act
VoiceOrder Solutions keeps real-time inventory visibility tied to order activity, and the catalog updates as stock levels change. A line sliding toward its 709 case trigger is then visible the same day.
